2025 Park Street Storm Project Phase III

  1. Project Information
  2. Project Updates

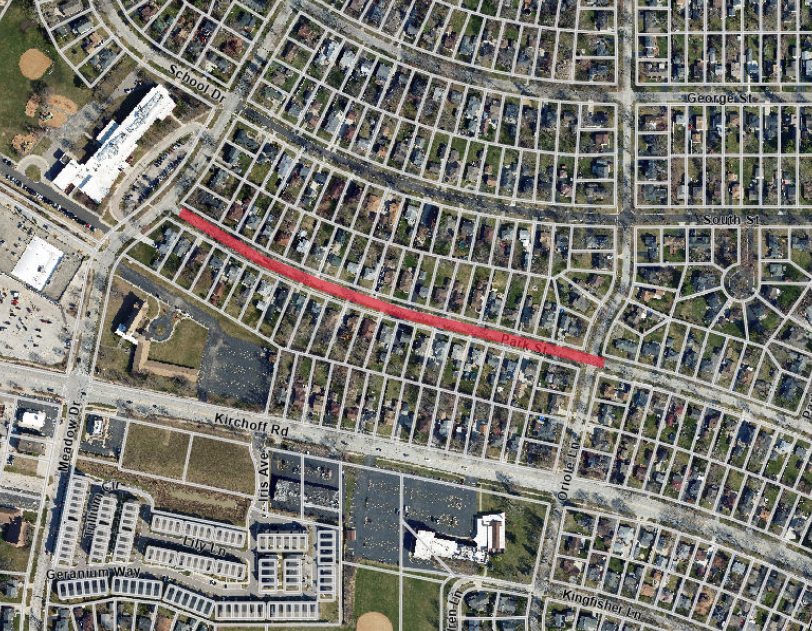

  3. Project Location Map
  4. Notifications
  5. FAQS
  6. Project Pictures

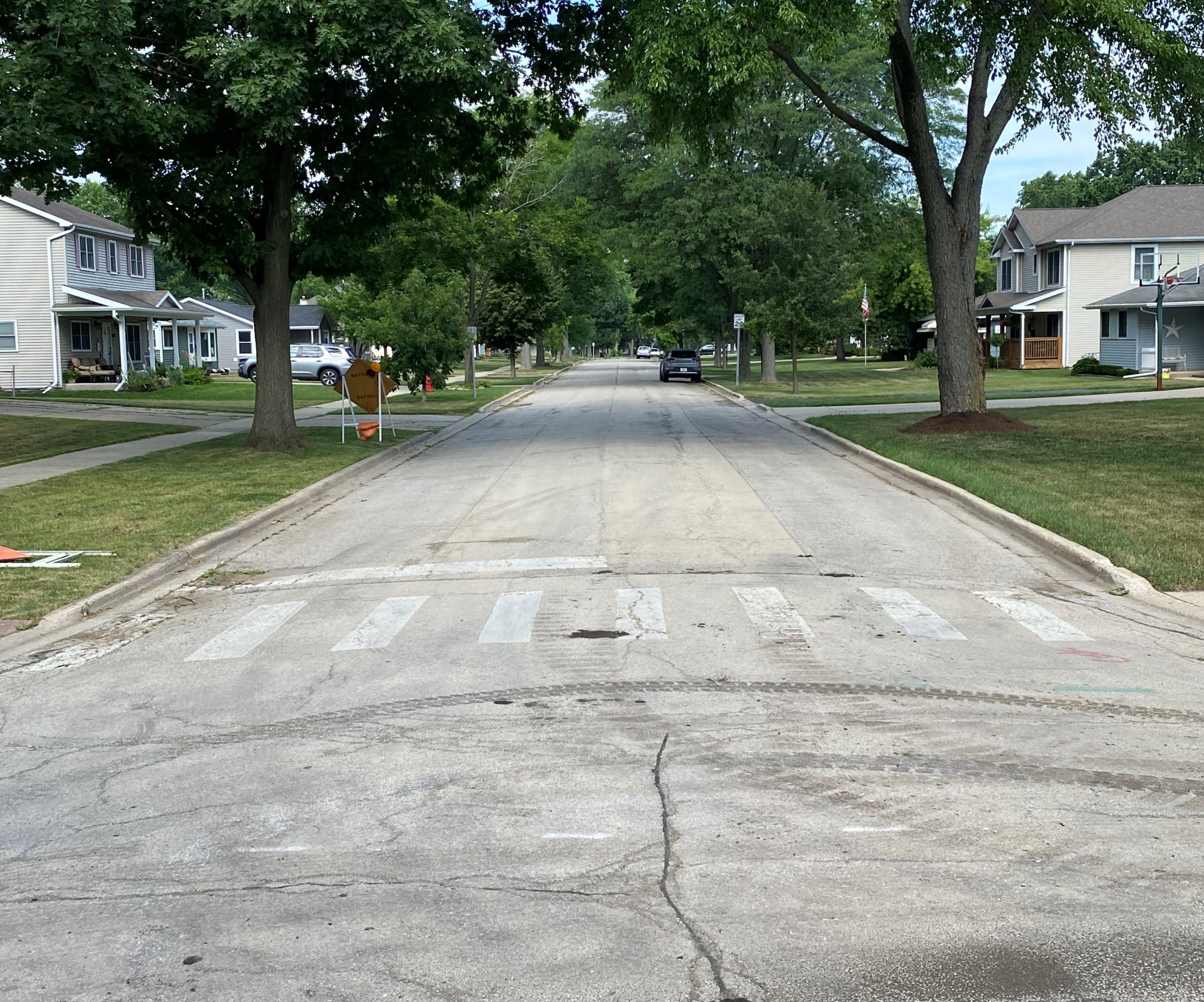

Park Street Photo



Project Information


This is Phase III of a project that has consisted of multiple phases.  Phase III will take place on Park Street (from Meadow Drive through the Oriole Lane intersection.)

Phase III will consist of installing approximately 2,000 linear feet of storm sewer ranging in size from 8-inch to 24-inch, storm manholes, catch basins, inlets, miscellaneous water and sanitary sewer service removal and replacements, pavement patching, grind and overlay, concrete curb and gutter removal and replacement, sidewalk removal and replacement, and  restoration.

 The new storm sewer will be installed in the roadway, so there will be a road closure to through traffic on Park Street  (from Meadow to Oriole Lane) during construction. The project has a substantial completion date of 9/1/2025.





Tentative Start Date:
August 4th 2025
Tentative Completion Date:
October 3rd, 2025
Bid Opening:
June 11, 2025
Project Manager:
Joel Benton, Project Coordinator
Contractor:
Concept Plumbing
Awarded Contract Amount:
$795,914.50
Funding Source:
Utilities Fund



Construction Limits

  • Park Street (from Meadow Drive through the Oriole Lane intersection)

Anticipated Hours of Work:

7:00 a.m.–6:00 p.m. Mon–Fri; 8:00 a.m.–5:00 p.m. Sat. (If necessary)
